Woven Geotextile Fabric Installation Guide

‌I. Pre-Construction Preparation‌

‌1. Material Preparation‌

  • Select woven geotextile fabric based on:
    • ‌Tensile Strength‌ (MD/CMD ≥ 20-100 kN/m per project specs)
    • ‌UV Resistance‌ (≥70% retained strength after 500 hrs ASTM D4355)
    • ‌Permittivity‌ (≥0.5 s⁻¹ for filtration compatibility)
  • Verify compliance with ‌ASTM D4595‌ (tensile) and ‌GRI-GT7‌ standards.

‌2. Site Preparation‌

  • Clear debris, rocks >50mm, and vegetation.
  • Compact subgrade to ‌≥90% Proctor density‌; achieve surface tolerance of ‌±25mm/3m‌.
  • Eliminate sharp protrusions to prevent puncture damage.

‌3. Equipment Readiness‌

  • ‌Critical machinery‌:
    • Geotextile deployment roller system
    • Mechanical seamer (for overlap joining)
    • Anchoring spikes/U-pins (stainless steel, min. length 300mm)

‌II. Step-by-Step Construction Procedure‌

‌1. Base Layer Installation‌

  • Place a ‌granular cushion layer‌ (crushed stone, 50-100mm thick) over subgrade.
  • ‌Key requirement‌: Particle size ≤40mm to prevent woven fabric abrasion.

‌2. Geotextile Deployment‌

  • Unroll woven geotextile ‌parallel to the primary stress direction‌ (e.g., slope contour, embankment axis).
  • Maintain ‌≥300mm overlap‌ at edges; prevent folds or creases.

‌3. Anchoring & Tensioning‌

  • Secure fabric every 1.5m using:
    • ‌U-pins‌ (staggered pattern, penetration depth ≥200mm)
    • ‌Sandbags‌ (25kg/m² at edges during windy conditions)
  • Apply slight tension (<3% elongation) to avoid slack.

‌4. Seaming & Overlap Joints‌

  • ‌Method 1‌: ‌Mechanical Sewing‌
    • Use UV-resistant polyester thread (ASTM D4356)
    • Stitch type: Double-lock, ≥4 stitches per 25mm

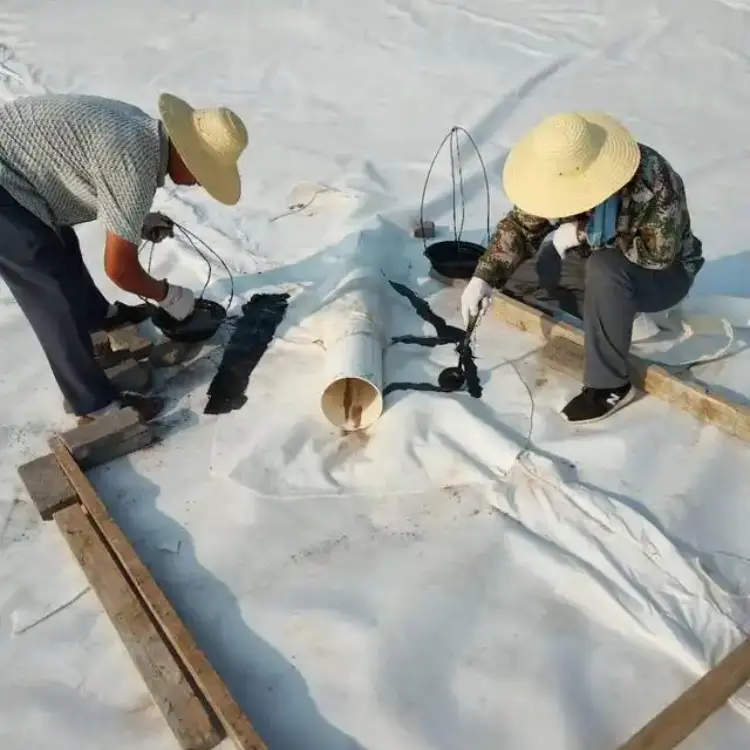

  • ‌Method 2‌: ‌Heat Welding‌
    • Temperature: 300-350°C (for PP/PE woven geotextiles)
    • Pressure: 0.2-0.4 MPa
  • ‌Min. seam strength‌: 80% of parent material strength.

‌5. Protective Cover Installation‌

  • Immediately cover with:
    • ‌Fill material‌: Angular aggregate (25-75mm gradation)
    • ‌Lift thickness‌: ≤300mm (compacted)
  • Initial placement via ‌backhoe from edge inward‌ to prevent displacement.

Woven Geotextile Fabric Installation Guide
Woven Geotextile Fabric Installation Guide

‌III. Critical Considerations for Woven Geotextiles‌

⚠️ ‌Directionality‌: Align ‌machine direction (MD)‌ with maximum stress vector (e.g., perpendicular to slope).
⚠️ ‌Abrasion Control‌:

  • Prohibit tracked equipment directly on exposed geotextile.
  • Use plywood mats for machinery transitions.
    ⚠️ ‌UV Degradation‌: Limit solar exposure to ‌≤48 hours‌ (cover or coat with bitumen if delayed).
    ⚠️ ‌Seam Integrity‌: Field-test seams via ‌vacuum chamber (ASTM D5820)‌ or ‌peel tests (ASTM D4884)‌.

‌IV. Post-Construction QA & Maintenance‌

‌1. Inspection Protocol‌

‌Checkpoint‌‌Acceptance Criteria‌
Seam continuityZero gaps >3mm
Surface deformationWrinkles ≤50mm height
Anchor spacing≤1.5m intervals
Cover thickness≥ design thickness +10%

‌2. Long-Term Maintenance‌

  • ‌Bi-annual audits‌: Inspect for:
    • Clogging (clean per EN 965 flow criteria)
    • Mechanical damage (patch with same-grade fabric +150mm overlap)
  • ‌Documentation‌: Maintain logs of strain gauges (if installed) and settlement markers.
